Reports & dashboard

  • The dashboard is personal and shows what to do next.
  • Reports show everyone how a project is going.

Neither needs extra input, and both are only as accurate as your issues.

Your dashboard

Open Home in the sidebar. At the top you see your name, the date and, if a sprint is running, which day of it you are on.

The Hinata dashboard The dashboard.

The active-sprint card

When a Scrum board has a sprint running, the large dark card shows:

  • the sprint's name and goal
  • chips for the sprint day, story points completed out of committed, and issues finished out of all issues
  • a ring with the progress as a percentage
  • avatars of everyone with issues assigned in the sprint

To board opens the board. Without a sprint, the card shows a Kanban overview whose progress counts finished issues instead of points. Without a board, it offers to plan a sprint.

Pin a board

By default the card picks the first running sprint among your projects. Use Customize to pin a fixed board.

The four key figures

Tapping a tile opens the Issues list filtered to exactly those issues.

TileWhat it counts
Today's tasksYour open issues due today or overdue, ordered by priority.
In ProgressEvery started issue in scope that is not done and not in the backlog.
BacklogEvery issue in scope in Backlog or Open.
DoneEvery issue in scope in one of your project's resolved states.

Only the first tile is about you

The other three count the whole team's work across every project on the dashboard.

Today's focus

The list shows the first five issues from Today's tasks, highest priority first. Each row has the type, title, key and, in red, how overdue it is. The thin bar on the right is time spent against the estimate, if there is one.

Tap a row to open the issue over the dashboard. All issues → opens the full list. If nothing is due, Hinata shows a short note.

Project progress

The donut shows the percentage resolved across every project in scope. The legend splits it into Done, In Progress and Backlog, with the total count in the corner. If Backlog is the biggest slice, more is coming in than going out.

Focus time

Only your logged hours: seven bars for the last seven days (today's in amber) and the total at the top. Week / Month shows the last five calendar weeks. It reads 0.0 h until work is logged. Time from Git commits is not included. See Tracking your time.

Team ranking and Git activity

  • Team ranking: the ten people who resolved the most issues in the last 30 days. It is meant light-heartedly and deliberately ignores hours.
  • Git activity: recent commits, pull requests and merges from connected repositories. Only shown once Git integration is set up.

Customize

Customize in the top-right starts edit mode.

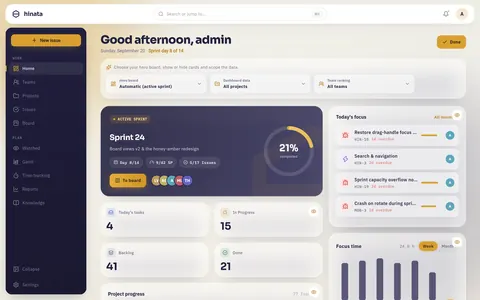

The dashboard in edit mode Edit mode.

  • The fields "Hero board", "Dashboard data" and "Team ranking" appear above the cards.
  • "Hero board" picks the board for the large card. The default is "Automatic (active sprint)".
  • "Dashboard data" sets which projects the key figures, donut and Today's focus count.
  • The eye button on a card hides it.

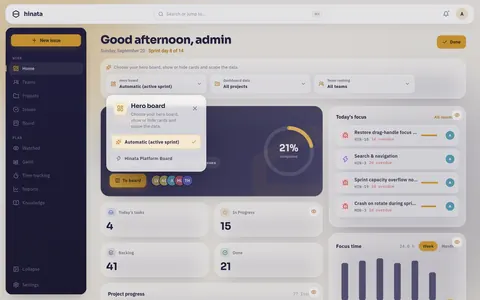

The hero board picker "Hero board" lists every board you can reach.

Done saves. The layout belongs to your account, so it also applies on your phone. Without Done, your changes are lost.

Reports

Open Reports in the sidebar, or under More on a phone. A report always shows one project. The picker under the heading only lists projects your team access grants you.

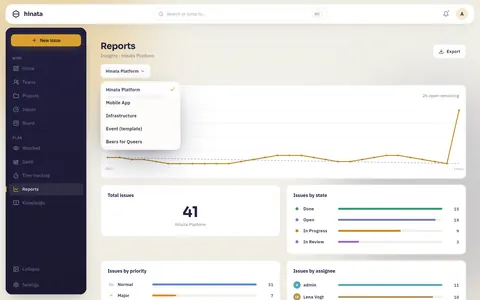

The project picker on the reports page The project picker.

Burndown · last 30 days

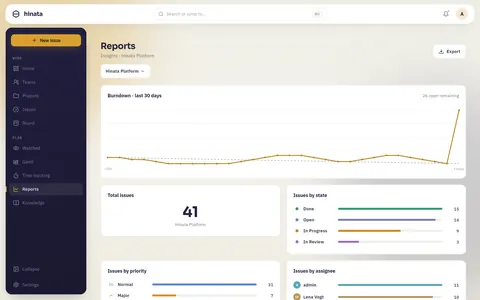

The reports page with burndown, total and states Burndown, total issues and states.

  • Amber line: open issues on each of the last 30 days, reconstructed backwards from today's count.
  • Dashed line: a straight path from the starting value to zero. It is only a reference.
  • Count in the top-right: today's figure. It is the only measured value.

What the shape means

  • Flat: work gets done as fast as it comes in.
  • Climbing: more comes in than gets done. Working faster will not fix it.
  • A drop near the end: issues sat in review or QA and were closed together. Where the delay was stays hidden.
  • Exactly on the line: be suspicious. Real work is uneven.

Total issues

Every issue that has ever existed in the project, resolved or not. Use it as the scale: 7 issues In Review out of 53 is a lot, out of 5,000 it barely matters.

Issues by state

One bar per state of your project, longest first, in the state's colour and with the count. Custom states such as In Parking or Signed off appear too. A pile-up in one state before done points to a bottleneck.

Issues by priority

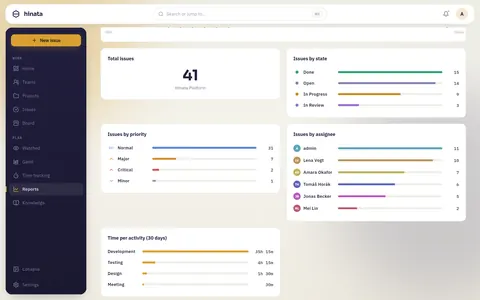

Priority, assignee and activity further down the reports page Priority, assignee and time per activity.

Look at the proportion. If nearly everything is urgent, it is time for a triage pass.

Issues by assignee

Issues nobody owns are collected under unassigned. Keep an eye on that row.

Counting issues is not measuring effort

Every distribution counts issues. Twelve tiny bugs outweigh one three-week migration here. Use the charts to spot patterns, and talk to people to find the reasons.

Time per activity (30 days)

Everyone's logged time on this project over the last 30 days, per activity type. Only time entries count, not time from Git commits.

Sprint burndown and velocity live on the board

Sprint metrics are on the board's Insights tab, next to Planning and Active sprint: sprint burndown, velocity across finished sprints, average velocity, scope changes and work breakdown by assignee. See Boards & sprints.

Reading the charts correctly

  • Check the time window. The burndown, time per activity and team ranking cover 30 days, the distributions all time. That is why they can seem to disagree.
  • Check your workflow. If everything sits in one vague In Progress, no report can show detail. Change that in the project settings.
  • Look for gaps. Missing bars say as much as tall ones.
  • Explain your numbers. "Fourteen issues are In Review because one person does every review" helps more than the number alone.

Exporting a report

Export in the top-right. Each export covers only the project on screen.

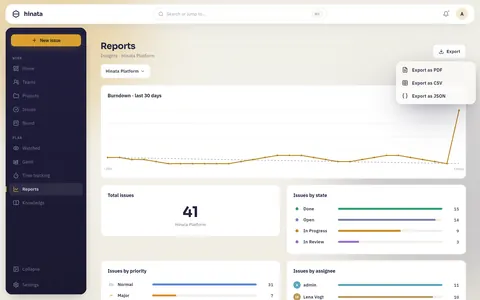

The export menu on the reports page The export menu.

  • Export as PDF: a printable A4 document with your organisation's name and logo, the project name, a generated-at timestamp, the total count, the burndown, every breakdown as a table (including time per activity) and page numbers. It arrives through the share or save dialog, named like hinata-report-Website-Relaunch-2026-08-20.pdf.
  • Export as CSV and Export as JSON: the same numbers as data. The web app downloads them. The desktop and mobile apps copy them to your clipboard and confirm with a toast.

Export right before you present

Every export is a snapshot with its generation time printed on it.

Reports show what you can see

The same visibility rules apply as in the rest of the app. See Projects & teams.
